All field notes

BIM Coordination

The Mechanics of BIM Coordination

Coordination Cycles, Clash Detection, and Issue Resolution. BIM coordination is more than running clash-detection software. This chapter explains how teams use structured coordination cycles, model-readiness checks, priority-based clash testing, and connected issue tracking to turn separate discipline models into one coordinated and constructible project.

The Mechanics of BIM Coordination

Chapter 3: The Mechanics of BIM Coordination

Coordination Cycles, Clash Detection, and Issue Resolution

In the previous chapter, we established the governance framework of a BIM project through the Project BIM Management Plan and BIM Execution Plans.

Once those documents are approved, however, the real coordination work begins.

Separate architectural, structural, mechanical, electrical, plumbing, civil, fabrication, and construction models must be reviewed together and transformed into one coordinated digital representation of the project.

How are the models collected and validated? Which systems should be tested first? How are irrelevant clashes filtered out? Who is responsible for each conflict? How is an issue tracked from its initial detection to its final closure?

The answer lies in a disciplined coordination process built around three connected mechanisms:

  1. A repeatable coordination cycle

  2. Structured clash detection and model review

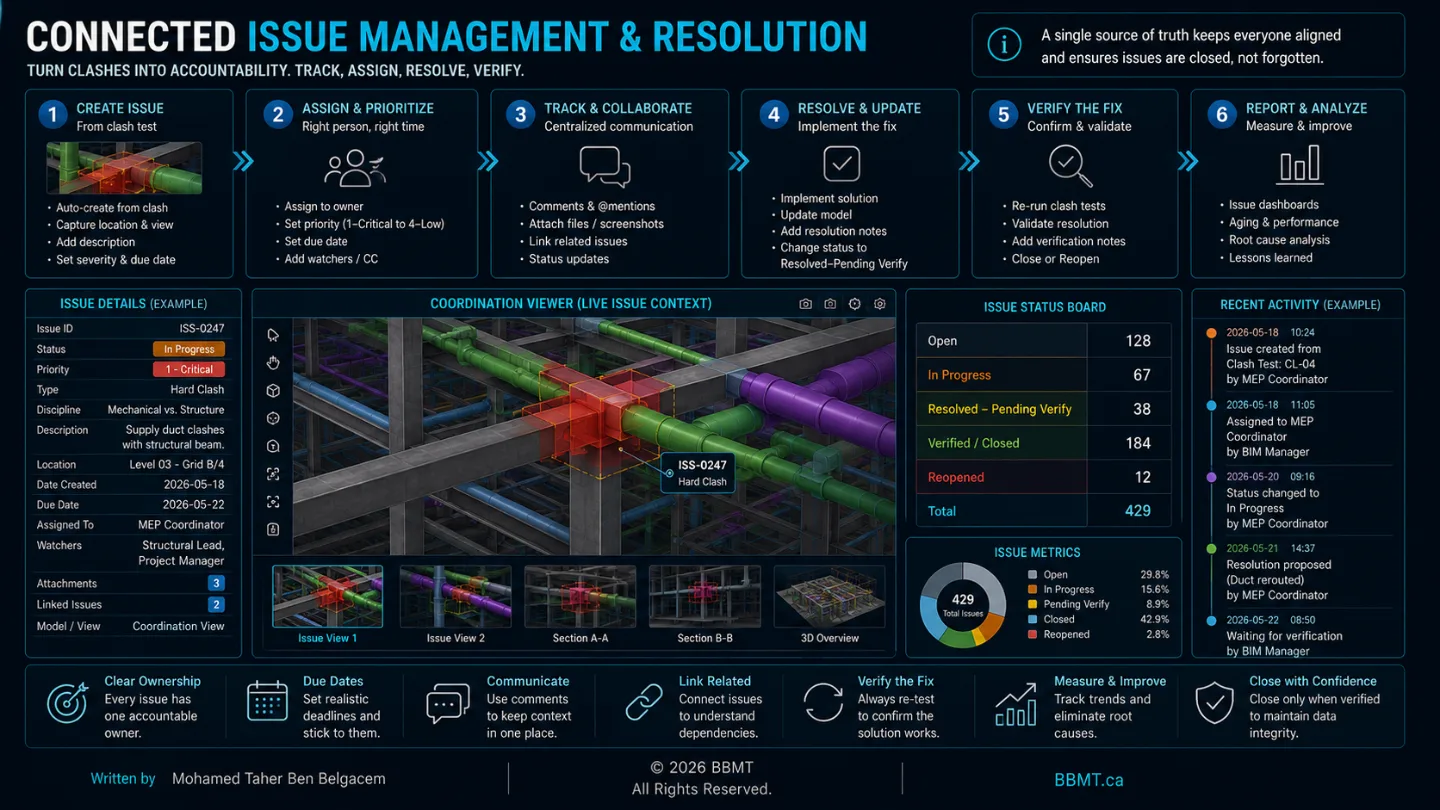

  3. Collaborative issue assignment, resolution, and validation

Three-dimensional coordination is one of the most valuable BIM applications because it allows project teams to identify geometric and spatial conflicts before those conflicts reach the construction site.

However, clash detection alone does not create a coordinated project.

Software can identify intersections. Only the project team can evaluate them, agree on solutions, modify the models, and confirm that the conflicts have been resolved.


1. The Coordination Cycle: A Repeatable Project Rhythm

BIM coordination is not a one-time event performed immediately before construction.

It is an iterative cycle of model production, internal review, information exchange, clash analysis, decision-making, correction, and validation.

A successful project requires a predictable coordination rhythm so every participant understands:

  • When models must be ready

  • When internal reviews must occur

  • When information must be shared

  • When coordination tests will be performed

  • When meetings will take place

  • When corrections are due

  • When issues will be validated and closed

The exact schedule should be established in the Project BIM Management Plan and reflected in each team’s BIM Execution Plan.

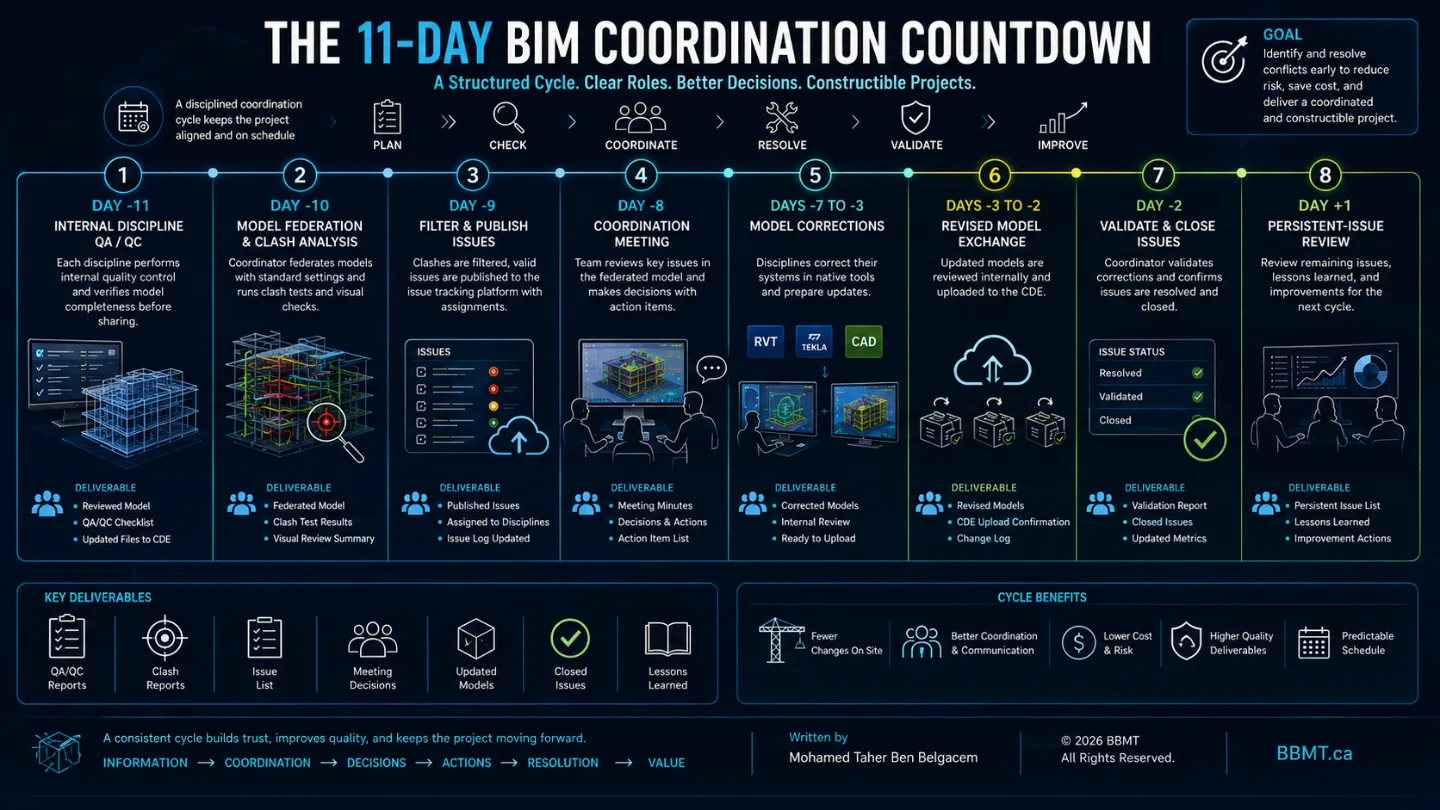

The following 11-working-day countdown is one example of a structured coordination cycle before a major project milestone.

Step 1 — Day −11: Internal Discipline Quality Control

Each discipline performs its own internal review before sharing information with the wider project team.

The team confirms that its model is sufficiently complete, correctly positioned, properly classified, and suitable for interdisciplinary review.

The internal review may include:

  • Model-health checks

  • Coordinate verification

  • Duplicate-element detection

  • Warning and error reviews

  • Naming-convention checks

  • Required-parameter checks

  • Model completeness reviews

  • Visual inspection

  • Export testing

Only models that pass the internal review should be uploaded to the Common Data Environment.

Step 2 — Day −10: Model Federation and Clash Analysis

The BIM coordinator collects the approved discipline models and loads them into the federated coordination environment.

Before running tests, the coordinator verifies:

  • File versions

  • Model origins

  • Shared coordinates

  • Units

  • Levels and grids

  • Model orientation

  • File names

  • Required discipline content

The coordinator then performs visual reviews and runs the agreed clash tests.

Step 3 — Day −9: Clash Filtering and Issue Publication

Automated tests may identify hundreds or thousands of intersections.

The coordinator reviews the results and removes:

  • Duplicate results

  • Approved penetrations

  • Intentional connections

  • Self-intersections

  • Minor or irrelevant contacts

  • Conflicts already covered by another issue

  • Results below the project’s reporting threshold

Valid coordination problems are converted into assigned issues.

Each issue should include:

  • A clear title

  • A visual viewpoint

  • The affected models or systems

  • The building, level, and zone

  • The responsible team

  • Priority or severity

  • Required action

  • Due date

  • Supporting comments or references

Step 4 — Day −8: Interdisciplinary Coordination Meeting

The project team reviews significant or unresolved issues using the federated model as a shared decision-making environment.

The purpose of the meeting is not to read every clash one by one.

The meeting should focus on issues that require:

  • Input from multiple disciplines

  • A design decision

  • A change in system routing

  • A structural or architectural modification

  • Owner approval

  • Construction sequencing input

  • Fabrication or installation expertise

Each issue should leave the meeting with a defined decision, responsible party, and deadline.

Steps 5 and 6 — Days −7 to −2: Model Corrections

The responsible model authors correct the identified conflicts in their native authoring platforms.

A modeler should not move an element simply to remove a clash symbol.

The correction must maintain:

  • Design intent

  • Code compliance

  • Required clearances

  • System performance

  • Constructability

  • Maintenance access

  • Fabrication requirements

  • Architectural quality

  • Structural integrity

Updated models are internally reviewed and shared again through the Common Data Environment.

Step 7 — Day −2: Resolution Validation

The BIM coordinator reloads the revised models and confirms that the assigned issues have been resolved.

Issues should only be closed when the corrected geometry or information is visible in the approved model.

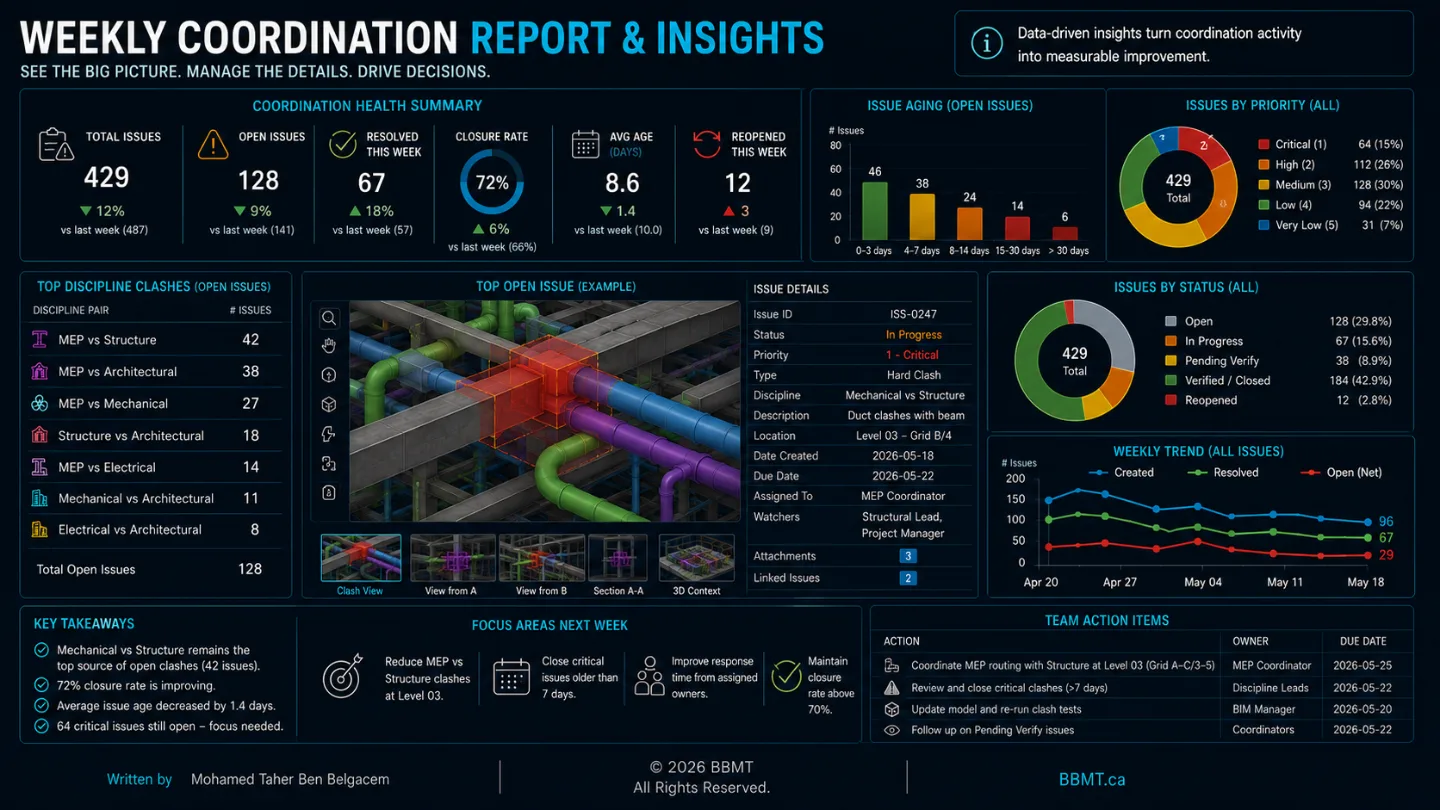

A verbal confirmation or meeting note is not sufficient evidence of closure.

Step 8 — Day +1: Persistent-Issue Review and Process Improvement

After the milestone, the project team reviews any persistent or unresolved issues.

This review may identify:

  • Issues requiring owner decisions

  • Conflicts delayed by incomplete design

  • Repeated coordination failures

  • Inadequate modeling standards

  • Missing information

  • Unrealistic deadlines

  • Problems in the current exchange workflow

The objective is not only to resolve remaining conflicts. It is also to improve the next coordination cycle.

A structured cycle creates accountability. Every discipline knows when its model must be ready, when decisions must be made, and when corrections must be completed.


2. Internal QA/QC: Clean Your Own Model First

One of the most important rules of professional BIM coordination is simple:

Internal discipline coordination must occur before interdisciplinary coordination.

The architectural team should not rely on the project BIM coordinator to identify architectural modeling errors.

The structural team should not submit overlapping beams, duplicated columns, or misaligned levels for the wider team to discover.

Mechanical, electrical, and plumbing teams should review their own systems for internal conflicts before testing them against architecture and structure.

When incomplete or poorly controlled models enter the coordination environment, the number of irrelevant clashes increases dramatically.

The result is wasted time, reduced confidence in the reports, and longer coordination meetings.

Typical Internal Model Checks

Before a model is shared, the discipline team should verify:

  • Model origin and coordinates

  • Grids and levels

  • Duplicate or overlapping elements

  • Disconnected system components

  • Orphaned objects

  • Objects placed on incorrect levels

  • Missing classifications

  • Incomplete required parameters

  • Incorrect object types

  • Excessive warnings

  • Imported or linked content

  • File size and model performance

  • Required clearances

  • Design completeness

  • Export quality

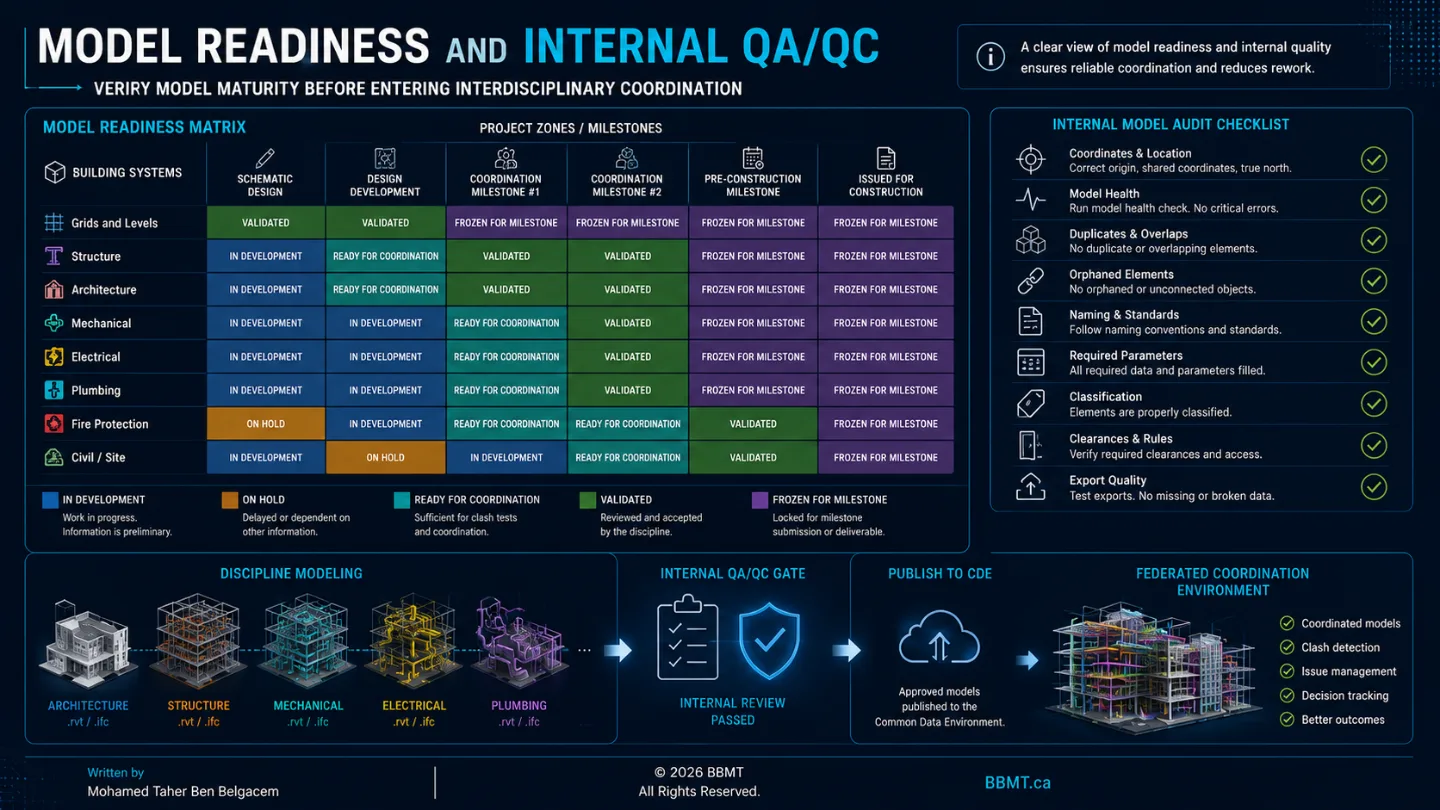

The Model Readiness Plan

A model should not be treated as either completely finished or completely unfinished.

Different systems and building zones may reach coordination readiness at different times.

A Model Readiness Plan helps the project team track the maturity of the information that will enter the coordination process.

The plan may list:

  • Grids and levels

  • Foundations

  • Structural framing

  • Building envelope

  • Interior partitions

  • Vertical circulation

  • Mechanical equipment

  • Ductwork

  • Plumbing systems

  • Fire-protection systems

  • Electrical distribution

  • Civil utilities

  • Landscape elements

  • Fabrication models

Each item can be assigned a clear status such as:

  • In Development

  • On Hold

  • Ready for Coordination

  • Validated

  • Frozen for Milestone

The purpose of the readiness plan is transparency.

The coordinator must know whether a model represents approved design information, preliminary routing, placeholder geometry, or incomplete work.

A clash involving two validated systems requires immediate action.

A clash involving a preliminary placeholder and an incomplete design may simply need to be monitored until more information is available.


3. The Clash Priority Matrix: Controlling the Signal-to-Noise Ratio

One of the most common mistakes in clash detection is running a single test between every element in every model.

This creates an overwhelming quantity of results.

Many of those results may be:

  • Intentional intersections

  • Low-priority finish conflicts

  • Duplicate clashes

  • Temporary design conditions

  • Minor tolerance contacts

  • Approved penetrations

  • Conflicts involving incomplete systems

  • Results that do not require a design change

When everything is tested against everything, critical issues become buried inside irrelevant data.

This is known as a poor signal-to-noise ratio.

Prioritize the Systems That Control Space

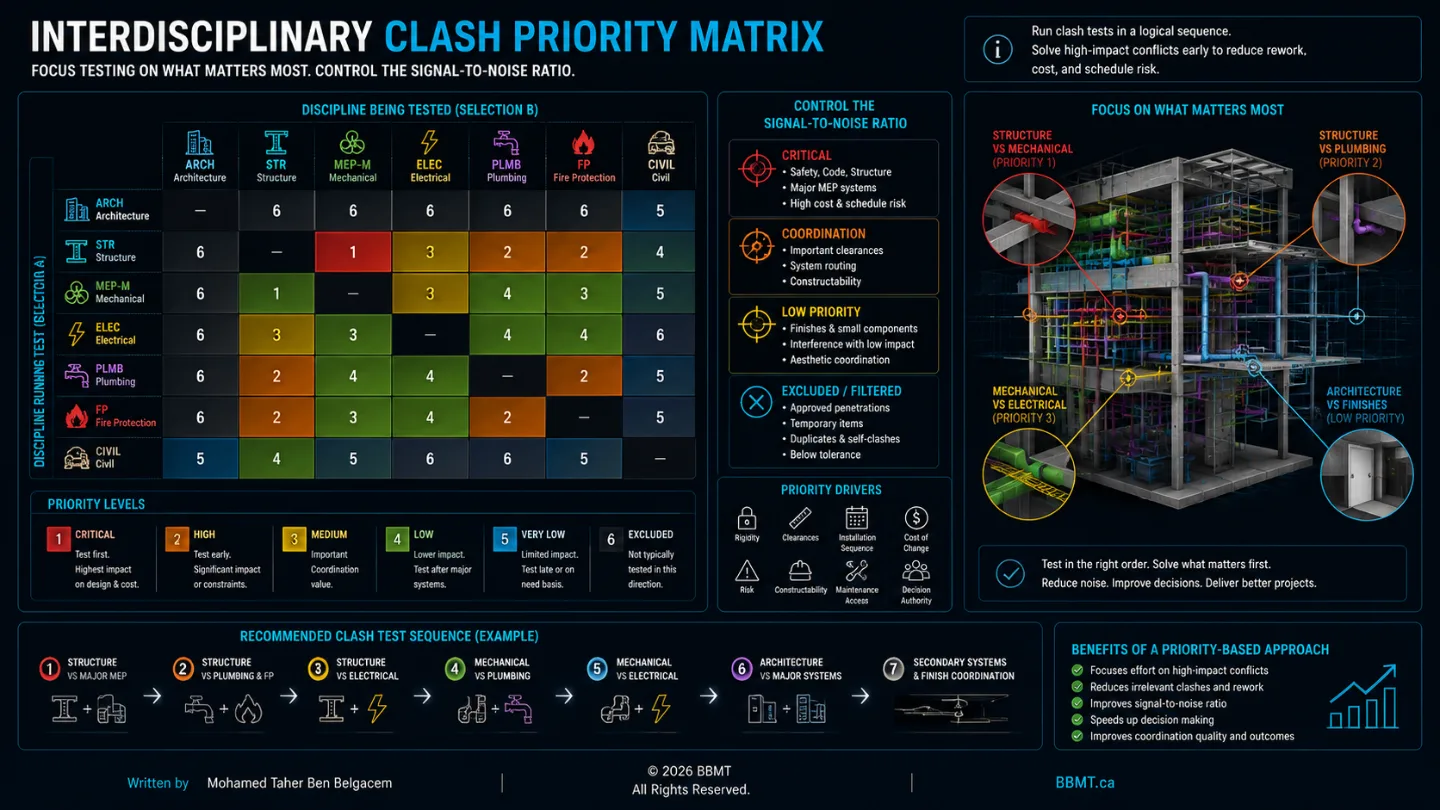

A clash priority matrix identifies which model categories should be tested against one another and in what order.

The matrix may consider:

  • System rigidity

  • Ability to reroute

  • Required clearances

  • Installation sequence

  • Cost of modification

  • Structural significance

  • Architectural impact

  • Fabrication status

  • Project risk

  • Decision authority

For example, a typical coordination sequence may begin with:

  1. Structure vs. major mechanical systems

  2. Structure vs. plumbing and fire protection

  3. Structure vs. electrical containment

  4. Major mechanical vs. plumbing

  5. Major mechanical vs. electrical

  6. Architecture vs. major building systems

  7. Secondary systems and finish coordination

This sequence is not universal. It should reflect the project’s construction system, design maturity, and coordination priorities.

Which System Should Move?

The clash matrix may also help establish which discipline normally has the greatest flexibility to adjust.

However, responsibility should never be determined only by a fixed hierarchy.

The correct solution may depend on:

  • Required slope

  • Structural loading

  • Minimum clearance

  • Ceiling height

  • Maintenance access

  • Fire rating

  • Installation sequence

  • Equipment performance

  • Fabrication restrictions

  • Cost and schedule impact

A large gravity drainage pipe may have less flexibility than a small electrical conduit.

A primary structural beam will generally have less routing flexibility than a branch duct.

A prefabricated assembly may be more difficult to modify than a system that has not yet entered fabrication.

The priority matrix helps the coordinator run focused tests and direct attention toward the conflicts with the greatest project impact.

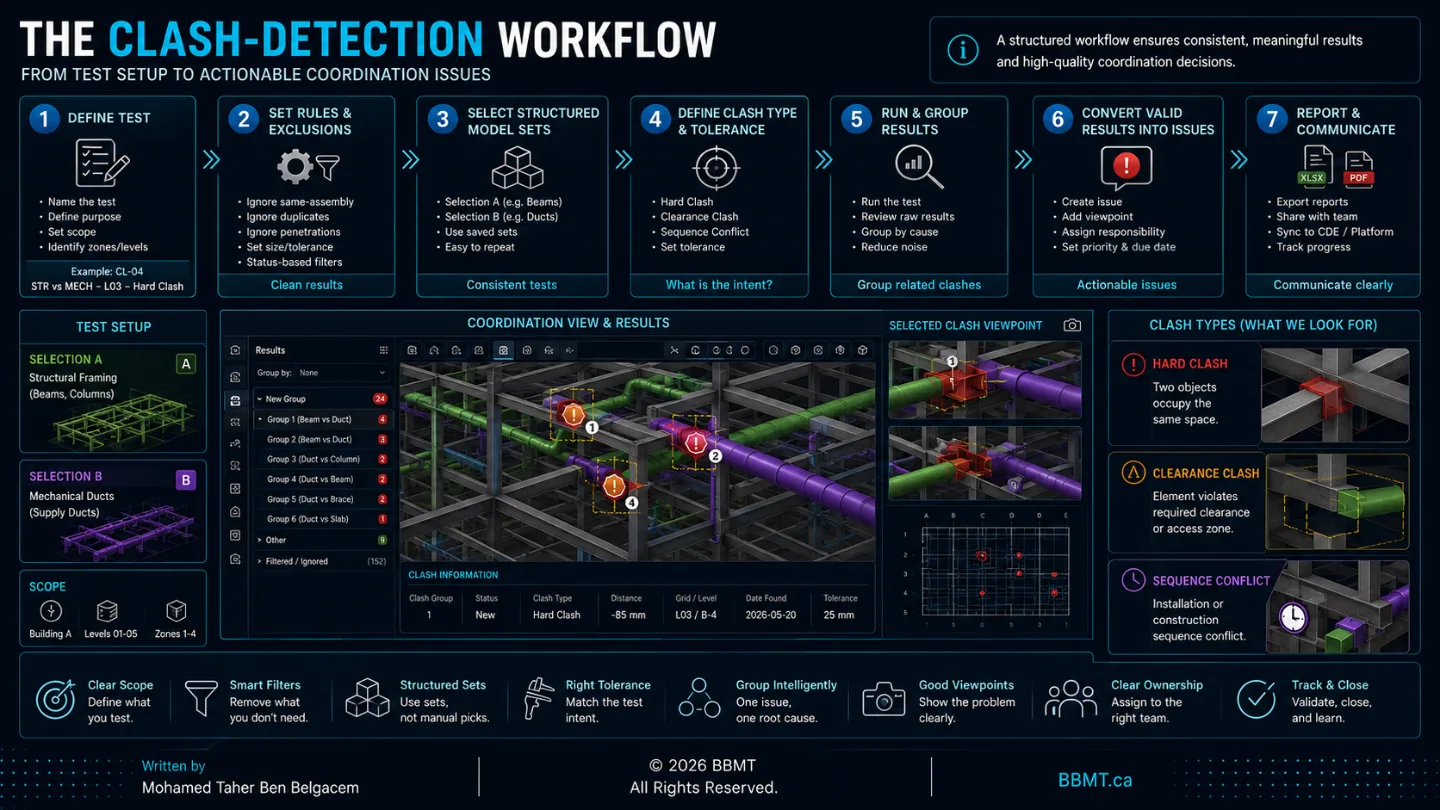

4. The Clash Engine: From Test Setup to Useful Results

Coordination platforms such as Autodesk Navisworks Manage, Solibri, Autodesk Construction Cloud Model Coordination, Revizto, and similar tools can automate geometric comparisons between models.

Although the interfaces differ, a disciplined clash-analysis process usually follows the same general sequence.

Step 1: Define the Test

Each test should have a clear and consistent name.

A useful naming structure may include:

  • Test number

  • Discipline A

  • Discipline B

  • Building or zone

  • Clash type

  • Revision date

For example:

CL-04 — Structure vs. Mechanical — Level 03 — Hard Clash

Clear test names make reports easier to understand and maintain.

Step 2: Define Rules and Exclusions

The coordinator establishes which conditions should be ignored.

Possible exclusions include:

  • Elements in the same approved assembly

  • Duplicate representations

  • Intentional penetrations

  • Linked reference geometry

  • Temporary construction objects

  • Elements below a defined size

  • Objects assigned to an excluded status

  • Previously approved exceptions

Exclusions should be documented. Hidden rules that only one coordinator understands create inconsistency and reduce trust in the results.

Step 3: Select Structured Model Sets

Tests should be based on organized selection sets rather than manually selected objects.

Examples include:

  • Structural beams

  • Structural columns

  • Concrete walls

  • Major supply ductwork

  • Sanitary drainage

  • Fire-protection mains

  • Electrical cable trays

  • Equipment clearance zones

  • Ceiling systems

  • Doors and circulation zones

Selection sets make tests repeatable when revised models are received.

Step 4: Define Clash Type and Tolerance

The coordinator determines what kind of conflict the test is intended to identify.

Common clash types include:

Hard Clash

Two physical objects occupy the same space.

Examples:

  • A duct passing through a beam

  • A pipe intersecting a concrete wall without an opening

  • Cable tray crossing structural bracing

Clearance Clash

An element violates a required access or maintenance zone.

Examples:

  • Equipment installed too close to a wall

  • Insufficient access in front of an electrical panel

  • Ductwork blocking a valve-maintenance zone

Workflow or Sequence Conflict

Two activities or installations cannot occur as planned because of timing, access, or construction sequence.

The project team should define tolerances according to the test purpose.

A tolerance appropriate for concrete structure may not be appropriate for finish coordination, fabrication, or maintenance-clearance analysis.

Step 5: Run, Review, and Group the Results

After the test is run, the coordinator reviews the clashes and groups related results.

A single design problem may generate several geometric clashes.

For example, one duct crossing a line of structural framing members may create multiple clash points. These should often be grouped into one coordination issue representing the underlying routing problem.

Grouping should be based on:

  • Common cause

  • Same system

  • Same location

  • Same required decision

  • Same responsible team

  • Same corrective action

Step 6: Convert Valid Results into Issues

A clash result becomes useful only when it is converted into an actionable issue.

The issue should explain:

  • What is wrong

  • Where it is located

  • Why it matters

  • Which team is responsible

  • What decision or correction is required

  • When the correction is due

Step 7: Report and Communicate

Reports may be exported in formats such as:

  • HTML

  • XML

  • PDF

  • Spreadsheet

  • BCF

  • Platform-native issue records

Static reports may still be useful for milestone records and formal submissions.

However, active coordination should preferably occur through a connected issue-management environment.

The quality of the clash results depends more on the test strategy than on the software.

A poorly structured test in advanced software will still produce poor coordination information.


5. From Static Clash Reports to Connected Issue Management

Historically, BIM coordination issues were documented through spreadsheets, screenshots, PDFs, and long email chains.

These methods create several problems:

  • Reports quickly become outdated

  • Issue ownership becomes unclear

  • Comments are distributed across different platforms

  • Modelers cannot easily locate the conflict

  • Closed issues may reappear

  • There is limited version history

  • Managers cannot reliably measure progress

  • Teams may work from different issue lists

Modern coordination platforms convert each issue into a controlled digital record.

The Issue Lifecycle

A well-managed coordination issue may move through the following statuses:

  1. Open — A valid issue has been identified

  2. Assigned — A responsible team or person has been selected

  3. In Progress — The team is evaluating or correcting the issue

  4. Ready for Review — A revised model has been submitted

  5. Resolved — The correction has been verified

  6. Closed — The issue is formally completed

  7. Reopened — The issue remains or has returned in a later model

Each issue should retain:

  • Creation date

  • Creator

  • Responsible team

  • Assigned person

  • Priority

  • Due date

  • Location

  • Model references

  • Viewpoint

  • Comments

  • Attachments

  • Status history

  • Resolution evidence

Direct Connection to Authoring Tools

Modern issue-management platforms may connect directly with authoring software.

A modeler can select an assigned issue and automatically open the relevant model view or location.

This reduces the time spent searching for:

  • The correct building

  • The correct floor

  • The correct room

  • The correct model elements

  • The exact clash coordinates

BCF-based workflows and platform integrations can transfer viewpoints, comments, selected elements, and issue metadata between coordination and authoring environments.

Live Coordination Analytics

Connected issue data allows project managers to monitor:

  • Open issues by discipline

  • Overdue issues

  • Average resolution time

  • High-risk zones

  • Repeated conflicts

  • Issue creation and closure rates

  • Milestone readiness

  • Model quality trends

The goal is not to create a dashboard for its own sake.

The goal is to identify coordination risk early enough for the project team to act.


6. The Coordination Meeting: From Clash Review to Decision-Making

A coordination meeting should not become a screen-sharing session in which the coordinator scrolls through hundreds of clashes.

The meeting must be structured around decisions.

Before the meeting, the coordinator should:

  • Filter the automated results

  • Group related clashes

  • Assign preliminary priorities

  • Identify the responsible disciplines

  • Separate simple issues from decision-level issues

  • Prepare clear viewpoints

  • Distribute the agenda

  • Confirm that the relevant decision-makers will attend

During the meeting, each issue should be reviewed by asking:

  1. What is the actual design or construction problem?

  2. Which requirements control the solution?

  3. Which systems can realistically move?

  4. Who has authority to approve the change?

  5. What is the agreed corrective action?

  6. Who is responsible?

  7. When is the revised model due?

After the meeting, decisions must be recorded in the issue-management platform.

A successful coordination meeting produces fewer unresolved questions, not simply more screenshots and comments.


Conclusion: Coordination Is a Team Process

Clash-detection software identifies geometric conditions.

It does not determine the best design solution.

It does not understand contractual responsibility, construction sequence, maintenance access, structural integrity, architectural intent, or project cost unless the project team provides that context.

True BIM coordination is therefore a collaborative process.

Success depends on architects, engineers, contractors, fabricators, coordinators, and model authors agreeing to:

  • Share reliable information

  • Follow a repeatable coordination cycle

  • Review their own models before submission

  • Prioritize meaningful clashes

  • Assign clear responsibility

  • Make timely decisions

  • Correct issues in the source models

  • Validate corrections before closure

  • Learn from repeated coordination problems

When teams resolve geometric and spatial conflicts in the virtual environment, they reduce uncertainty before construction begins.

The result is not necessarily a model with zero detected intersections.

The real objective is a coordinated, constructible, maintainable, and clearly documented project in which the remaining risks are understood and accepted by the responsible participants.

The Mechanics of BIM Coordination | BBMT Inc.
